Project kick-off meeting agenda: what to include and why
A section-by-section project kick-off meeting agenda, the exact questions to ask in each block, and how to adapt it for internal vs client projects.
Updated June 12, 2026
A good project kick-off agenda is not a list of topics. It is a set of questions the meeting has to answer out loud, in order, before anyone commits real hours. Every section earns its place because it forces a specific decision: why this project exists, what is in and out of scope, who is the single accountable owner of each workstream, and what "done" actually means. If your agenda is a bullet list of nouns (purpose, plan, roles, Q&A) without the questions underneath them, you will hold a pleasant meeting and leave with nothing written down. This guide gives you the seven sections, the questions to ask in each, and how to bend the agenda for an internal team versus a client.
If you just want a timed, minute-by-minute script to paste into a calendar invite, use our agenda for a project kick-off meeting instead. This post is the why behind each block, so you can build an agenda that fits your project instead of running someone else's clock.
The seven sections every kick-off agenda needs
Asana's project kick-off guide lays out a ten-step flow, and the heart of it is a sequence of sections that each answer a question (Asana, "Project kickoff meeting: 10-step guide," accessed 2026-06-13). Strip it to the essentials and you get seven sections. Here they are with the question each one exists to answer.
- 1
Introductions
Who is in the room, and what does each person own? Name, role, contribution. Keep it to one sentence each.
- 2
Purpose
Why are we doing this, and why now? What does success look like? Two questions, one agreed answer each.
- 3
Plan + milestones
What are the key dates, milestones, and deliverables? Not every task, just the spine and the critical path.
- 4
Scope: in and out
What is in scope, what is explicitly out, and how does a change get approved? Write both lists live.
- 5
Roles + responsibilities
Who is the single accountable owner of each workstream? Use a RACI if there is any doubt.
- 6
Source of truth + comms
Where does the work live, and how do we talk to each other? One place for status, one cadence.
- 7
Questions + next steps
What is still unclear, and who owns each open item? Read the action items back aloud before anyone leaves.
The order matters. Purpose comes before plan because a plan without an agreed outcome is just a list of activity. Scope comes before roles because you cannot assign an owner to work you have not bounded. And questions come last, after everything else is on the table, so the open items that remain are real gaps and not just things you had not gotten to yet.
Section by section: the questions to ask
1. Introductions (keep them to a sentence)
The point of introductions is not warmth, it is mapping. Everyone says their name, their role, and the one thing they own on this project. That last part is what people skip, and it is the part that matters. "I'm Dana, I run design" is a name tag. "I'm Dana, I own the design system and I'm the person who signs off on visual QA" tells the room who to go to. Keep each intro to a sentence so you do not burn the first ten minutes on icebreakers.
2. Purpose (two questions, no more)
Asana frames the purpose block around two questions: "Why are we working on this?" and "What are we working towards?" (Asana, accessed 2026-06-13). The first connects the project to a business goal so people understand the stakes. The second defines what success looks like in measurable terms. Do not let this section become a backstory monologue. You want one agreed sentence for each question, written down, that everyone in the room would repeat the same way.
3. Plan and milestones (the spine, not the whole skeleton)
Share the project plan at altitude. Asana is explicit that you should focus on the timeline, key milestones, and deliverables, not walk through every task (Asana, accessed 2026-06-13). The questions to answer here: what are the major milestones and their dates, what is the critical path, and where are the dependencies on the client or on another team? The detailed task breakdown belongs in your project tool, not in the kick-off. If you find yourself reading line items off a Gantt chart, you have dropped too low.
4. Scope: in, out, and the change process
This is the section that prevents the project from quietly doubling in size. Do not describe scope in prose. Open two lists on the shared screen, "In scope" and "Out of scope," and fill them live while everyone watches. The out-of-scope list is the one people skip and the one that saves you, because it is the written record you point to when someone asks for "just one small addition" in month two.
Then answer the question everyone forgets: how does a change get approved? Who can request it, who signs off, and what does an approved change do to the timeline and the budget? A scope boundary with no change process is a boundary that erodes the first time someone leans on it. For the full defense, see how to prevent scope creep.
5. Roles and responsibilities (one accountable owner each)
Listing who is on the team is not the same as assigning accountability. The question to answer is sharper: for each workstream, who is the single person who answers for it being done? A RACI matrix is the cleanest way to write this down. It gives every workstream four roles: Responsible (does the work), Accountable (the one owner who answers for completion), Consulted (gives input before the work is done), and Informed (kept in the loop).
6. Source of truth and communication
Answer two operational questions. First: where does the work live? Pick one place for the project plan, the docs, and the status, and say it out loud so nobody is hunting through email threads in week three. Asana calls this a central source of truth (Asana, accessed 2026-06-13). Second: how do we communicate? Set the status cadence (weekly update, standup, whatever fits), the channel for quick questions, and the response-time norm so expectations are explicit instead of assumed.
7. Questions and next steps
Save real time for questions. Then close with the part that makes the whole meeting durable: read the action items back aloud, each with an owner and a due date. Every open question that did not get answered gets assigned to a person with a date, so nothing is left as a vague "we'll figure it out." This is the section where alignment becomes a record. For the format, our action items template keeps it consistent across projects.
Internal vs client kick-off: same sections, different weight
The seven sections work for both, but the emphasis shifts. Asana's guidance is that an internal kick-off aligns the delivery team on objectives, roles, and cadence with little polish, while a client kick-off is the most polished version, built to set expectations, establish business value, and build trust (Asana, accessed 2026-06-13). At an agency, run the internal kick-off first to pressure-test the plan, then face the client with a clean story.
- Goal: align the delivery team on objectives, roles, and workflow.
- Heaviest sections: Roles/RACI and Plan/milestones.
- Polish: low. Whiteboard and argue freely.
- Run it first to find the plan's weak spots before a client does.
- Skip: the trust-building and business-value framing; the team already shares context.
- Goal: set expectations, establish business value, build trust.
- Heaviest sections: Scope boundary + change process, and Comms.
- Polish: high. This is the most polished version.
- Add: the client-side approval owner and the cross-org escalation path.
- Name the budget boundary explicitly so scope changes have a cost attached.
If you run client work, three add-ons matter beyond the standard seven: name the client-side approval owner (the person who signs off on deliverables), agree the budget boundary so scope changes carry a price, and write down the escalation path between the two organizations. Our guides on managing client expectations and the agency project workflow go deeper on the relationship side, and how to manage multiple projects helps when you are juggling several kick-offs at once.
How long, and who should be there
Keep the room small and the clock honest. Asana recommends 5 to 10 attendees: the people who can decide and the people who will do the work, not a gallery of observers (Asana, accessed 2026-06-13). The standard cast is the project sponsor, the project manager or lead, the delivery leads for each workstream, and, on a client engagement, the client owner and their approval authority. If someone only needs the outcome, send them the recap instead of a seat.
Send the agenda ahead of time. Asana is direct about this: distribute the agenda before the meeting so people come prepared (Asana, accessed 2026-06-13). If attendees walk in cold, you spend the hour delivering context a one-page brief could have carried, and you run out of time before the sections that prevent failure. Our meeting preparation checklist covers the full pre-send routine.
Capture the agreements so they survive the meeting
You fought for written scope, a clean RACI, and a measurable purpose statement. All of it evaporates if the only record is a few hurried notes. The durable output of a kick-off is three things: a decisions log, action items with owners and due dates, and ideally a transcript, distributed the same day before anyone's memory fades. Asana's own final steps are to share the notes and capture the action items after the meeting (accessed 2026-06-13).
If your team is on a paid Google Workspace plan, native Meet recording can help, but know the limits. Recording is available on specific editions (Business Standard and Plus, the Enterprise tiers, Education Plus, Workspace Individual, and similar), an admin has to turn it on for your account, and the file saves to the organizer's Meet Recordings folder in Drive (Google Meet Help, "Record a video meeting," accessed 2026-06-13). A raw recording is not a decisions log or an action-item list, though. Someone still has to watch it back and type those up.

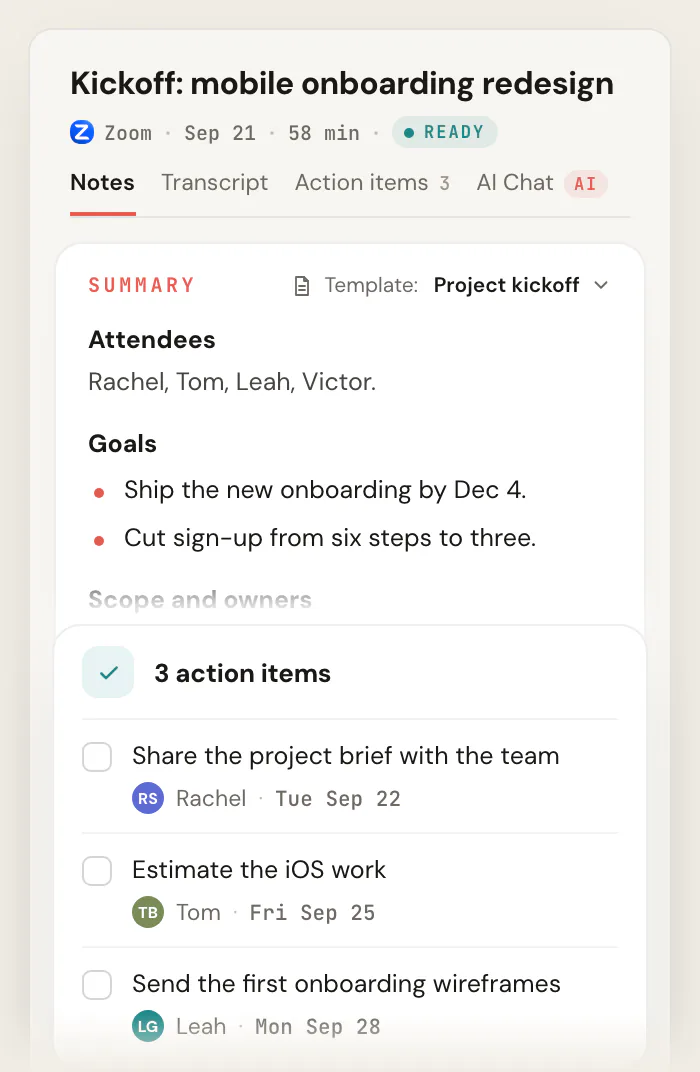

This is one of the few places Scribbl is honestly the right tool. Scribbl is an AI notetaker for Google Meet that records, transcribes, and auto-extracts action items from your kick-off with no bot sitting in the call, then produces a shareable recap. It runs from the browser, it is free for individuals, Pro adds unlimited recording, and Team adds Zoom and Microsoft Teams. For project managers, the PM workflow is the same loop on every project.
Kick-off recap
- Decision: purpose statement agreed agreed
- Decision: scope boundary set agreed
- Action: circulate signed brief PM · Fri
- Action: confirm staging access Client · Mon
- Action: book sprint-1 review Lead · Tue
The full loop: send the agenda and pre-read ahead, run the meeting section by section, capture decisions and action items as they are agreed, then distribute the recap before everyone leaves the call. For the manual version of the notes step, see how to take better meeting notes, and for tracking the follow-through, action item tracking.
Frequently asked questions
What should a project kick-off agenda include?
Seven sections, each tied to a question: introductions (who owns what), purpose (why this, and what success looks like), plan and milestones (key dates and the critical path), scope (in, out, and the change process), roles (one accountable owner per workstream), source of truth and communication (where work lives and how you talk), and questions plus next steps (open items and action items with owners). Asana's ten-step guide expands this list with prep and post-meeting steps (accessed 2026-06-13).
What questions should I ask in the purpose section?
Two: "Why are we working on this?" to connect the project to a business goal, and "What are we working towards?" to define success in measurable terms (Asana, accessed 2026-06-13). The output is one agreed sentence for each that everyone in the room would repeat the same way. If the answers are vague or contested, do not move on until they are settled.
How is this agenda different from a project charter?
The agenda is the script for the meeting; the charter is the artifact it produces. Each agenda section fills a charter section: purpose, scope, milestones, team, risks, exit criteria. When the charter is filled in and signed off by the sponsor, the kick-off is genuinely done. Our project summary template gives you a fill-in-the-blank starting point.
Should the kick-off be different for an internal project versus a client one?
Same seven sections, different weight. An internal kick-off leans on roles and the plan and stays low-polish so the team can argue freely. A client kick-off leans on the scope boundary and communication, runs polished, and adds three things: the client-side approval owner, an explicit budget boundary, and the cross-organization escalation path (Asana, accessed 2026-06-13). When you run agency work, brief the team internally first.
Do I need to record the kick-off?
You need a durable record, which is not the same as a video file. The minimum is a decisions log and action items with owners and due dates, shared the same day. A recording and transcript make that easier and let people who missed it catch up. Native Google Meet recording needs a paid Workspace edition with an admin toggle and saves to the organizer's Drive (accessed 2026-06-13); a tool like Scribbl works on free Google accounts and turns the call into a recap with action items automatically.
Try Scribbl
Let your meetings take their own notes.
Scribbl records, transcribes, and summarizes your Google Meet calls from your browser. No bot joins the call. Free forever for individuals.
Add to Chrome · It's free
